High-Grade Gold, Proven Ground

AcceleratingTowards Production

Advancing the past-producing Scottie Gold Mine in British Columbia's Golden Triangle — 703,000 oz of high-grade gold on a permitted, road-accessible land package.

[ About Scottie ]
703 kOzInferred gold resource at 6.06 g/t — released May 2025

Scottie Resources is transforming a past-producing, high-grade gold mine into BC's next producer. With a 703,000 oz resource, a robust PEA, an existing mine permit, and smart-money backing, the company is accelerating through feasibility towards production in 2028.

60.3%After-tax IRR at US$2,600 gold — 2025 PEA base case
1.2 yrsMine payback under the DSO base case

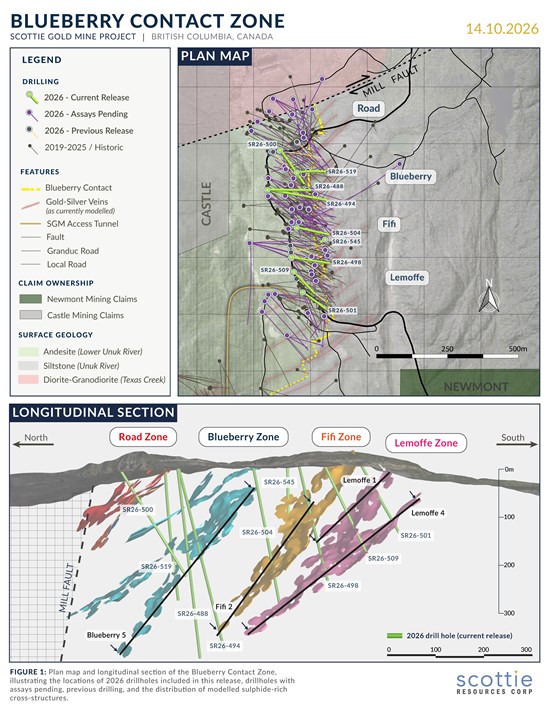

55,000+ mDrilled in 200 holes in the fully funded $26M 2026 program (as of Oct 14, 2026)
[ Path to Production ]

A Smarter Route to Production

Using ore sorting technology, Scottie's Direct Shipping Ore operation eliminates the need for a processing plant and tailings facility — significantly reducing capital requirements and the environmental footprint.

$128.6MInitial capital cost — a fraction of a typical mill build
94.7%Gold recovery through the sorting circuit
40 kmTo the deep-water port of Stewart on a 4-season road
M139Existing mine permit in place — pathway to near-term production

Scottie Gold Mine DSO Operation

Open-pit start-up de-risks the project with rapid payback, before transitioning underground at Blueberry and the historic Scottie Gold Mine. Sorted ore ships through one of the lowest-cost shipping lanes between North America and Asia.

See the Economics →
Driller working on the rig at Scottie
Drill mast against the sky
[ The Golden Triangle ]

Surrounded by Majors

The past-producing Scottie Gold Mine sits in the heart of BC's Golden Triangle — a Tier 1 jurisdiction where Newmont, Teck, and Seabridge have committed billions. Scottie's 58,500-hectare package hosts seven past-producing mines with road, power, and port infrastructure in place.

  • Newmont · Brucejack$3.5B takeover of the mine next door — 350,000 oz of gold per year.
  • Seabridge · KSM88 Moz measured & indicated gold deposit on the same trend.
  • Skeena · Eskay CreekUS$750M financing with Orion to build the 5.2 Moz AuEq project.
  • Teck · Schaft Creek$34B major holding 7.7B lb of copper and 6.9M oz of gold in the district.
See the Land Package →
TatoggaRed ChrisSchaft CreekGalore CreekSnipEskay CreekTreaty CreekKSMBrucejackPremierHomestakeTHE PAST-PRODUCINGSCOTTIE GOLD MINEGOLDEN TRIANGLE · BRITISH COLUMBIA

Economics at Every Gold Price

The October 2025 Preliminary Economic Assessment models a 7-year DSO operation averaging 65,400 oz of gold per year at 6.86 g/t — with payback in just over a year at conservative prices.

[ $2,600 /oz Gold ]
$215.8M after-tax NPV (5%)
PEA base case
  • After-tax IRR 60.3%
  • Mine payback 1.2 yrs
  • NPV to capex 1.7x
  • Mine life 7 years
Read the PEA
[ $3,400 /oz Gold ]
$442.0M after-tax NPV (5%)
Closest to spot gold
  • After-tax IRR 107.9%
  • Mine payback 0.8 yrs
  • NPV to capex 3.4x
  • Mine life 7 years
Read the PEA
[ $4,200 /oz Gold ]
$668.3M after-tax NPV (5%)
Upside case
  • After-tax IRR 153.2%
  • Mine payback 0.6 yrs
  • NPV to capex 5.2x
  • Mine life 7 years
Read the PEA

PEA DSO Base Case, released October 28, 2025. After-tax values, NPV at 5% discount rate. Toll milling scenario at US$2,600/oz gold: $380.1M NPV, 89.9% IRR.

[ Validation ]

Real Backing. Real Conviction.

Franco-NevadaRoyalty & Equity Partner

2% gross production royalty acquired for $8.1M CAD, alongside a $1.5M CAD equity investment in the company.

Ocean PartnersFinancing & Off-take Partner

$6M equity investment plus a US$25M construction and overrun facility, with an off-take agreement for future production.

Analyst CoverageAgentis · Cormark · Velocity

Institutional research coverage from Agentis Capital, Cormark Securities, and Velocity Capital, with 70% of the register held by insiders and institutions.

The Team Taking Scottie Back to Production

Full Team →
Bradley RourkeBradley RourkeExecutive Chair
Thomas MumfordThomas MumfordPresident & CEO · Ph.D, P.Geo
Sean MasseSean MasseChief Operating Officer · P.Eng

Directors & Officers — Ernest Mast, M.Eng, P.Eng · John Williamson, P.Geol · Steven Stein · Ellie Owens, J.D., M.Sc · Brent Omland · Chris Noon, CPA (CFO) · Christina Boddy, B.Sc (Corporate Secretary)

The Road to First Gold

An existing mine permit, completed PEA, and funded feasibility work put Scottie on one of the shortest development runways in the Golden Triangle.

2026

Feasibility & 55,000+ m

Largest drill program in company history, feasibility-level engineering, and year two of environmental baseline studies.

Mid 2027

Feasibility Study

Feasibility study and resource update, with detailed engineering and early works following.

Late 2027

Permit Application

Environmental baseline complete and permit application submitted, in collaboration with First Nations partners.

2028

Production

Permit targeted mid-2028, construction, and first gold by the end of 2028.
